Roads 2021: Pavement Management and Collector/Arterial Program

Share Roads 2021: Pavement Management and Collector/Arterial Program on Facebook Share Roads 2021: Pavement Management and Collector/Arterial Program on Twitter Share Roads 2021: Pavement Management and Collector/Arterial Program on Linkedin Email Roads 2021: Pavement Management and Collector/Arterial Program link

Consultation has concluded

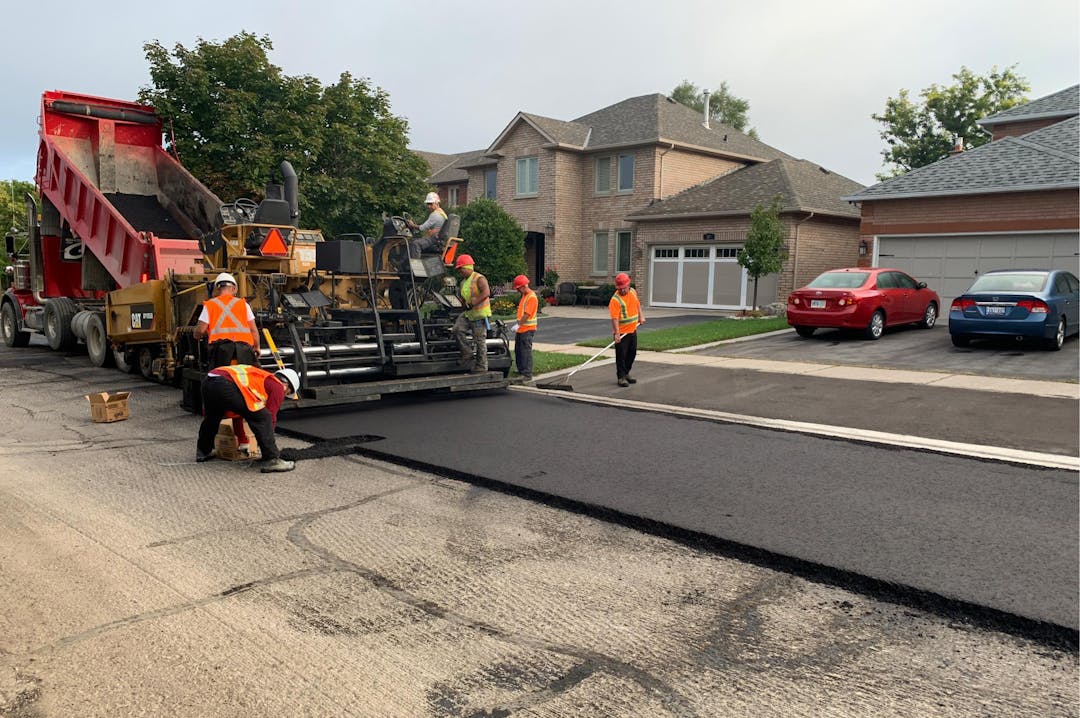

Paving Craig Cres

Each year, the Design and Construction Section of the Transportation and Public Works Department delivers Pavement Management and Capital Works construction programs in order to renew and improve infrastructure across Halton Hills. Pavement Management has been an annual local resurfacing program since 2003 and the Collector/Arterial resurfacing program which focuses on upgrading collector and arterial roads in Halton Hills is scheduled to commence in 2021 and executed on a by-annual basis.

Starting in the spring of 2021, select streets will benefit from road resurfacing and road reconstruction where needed. This work will be managed and administered by the Design and Construction Section, Transportation and Public Works Department.

The Town of Halton Hills is planning to perform improvements to the following streets:

Street

Road Span

Type of Work

Bairstow Crescent

Prince Charles Drive to Prince Charles Drive

Reconstruction

Credit Street

Confederation Street to End

Minor Reconstruction

Eaton Street

Miller Drive to Barber Drive

Resurfacing

15 Side Road

Regional Road 3 (Trafalgar Road) to 300m E of Trafalgar Road

Resurfacing

Hepburn Crescent

Argyll Road to Miller Drive

Resurfacing

Morris Street

Chapel Street to End

Resurfacing

Rexway Drive

Sargent Road to Heslop Court

Resurfacing

Sinclair Avenue

Mountainview Road to Duncan Drive

Resurfacing/Active Transportation

22 Side Road

Fourth Line to Fifth Line

Resurfacing

22 Side Road

Regional Road 25 to Pit Entrance East of Third Line (East Leg)

Resurfacing


Project Summary by Street:

Bairstow Cres., Prince Charles Drive to Prince Charles Drive – Reconstruction

Full-depth asphalt removal, add new curbs, new storm sewer or repairs and full width asphalt. Restoration of driveways (full aprons, curb to sidewalk, or full width to the damaged limit) all damaged grassed areas restored with topsoil and sod.

Credit Street, Confederation Street to End – Minor Reconstruction

Full depth asphalt removal, curb repairs in areas, add curb between Confederation and Beaver and Erin to End. Add storm sewer and full width asphalt. Restoration of driveways (full width to the damaged limit) all damaged grassed areas with topsoil and sod.

Rexway Drive, Sargent Road to Heslop Court - Resurfacing

Full depth asphalt removal, curb repairs in pre-identified areas and full width asphalt resurfacing. Restoration of driveways (full aprons, or full width to the damaged limit) all damaged grassed areas with topsoil and sod.

Morris Street, Chapel Street to End - Resurfacing

Excavation and re-grade road to allow for center line drainage, redirecting drainage from private properties. Repave asphalt full width of road. Restoration of driveways (full width to the damaged limit) all damaged grassed areas restored with topsoil and sod.

22 Side Road, Fourth Line to Fifth Line - Resurfacing

Pulverize existing asphalt into granular base, re-grade pulverized granular material. Repave asphalt full width of road. Restoration of driveways (full width to the damaged limit) all damaged grassed areas with topsoil and sod or seed.

Eaton Street, Miller Drive to Barber Drive and Hepburn Cres., Argyll Road to Miller Drive - Resurfacing

Mill (remove) top asphalt lift, base asphalt repairs as required. Repave asphalt full width of road. Curb repairs in pre-identified areas. Restoration of driveways (full aprons, or full width to the damaged limit) all damaged grassed areas restored with topsoil and sod.

Sinclair Ave., Mountainview Road to Duncan Drive - Resurfacing/Active Transportation

Full depth asphalt removal, curb repairs in pre-identified areas. Storm sewer repairs and full width asphalt. Add active transportation (multi-use path) on north side and lay-by-lane in front of school. Restoration of driveways (full aprons, or full width to the damaged limit) all damaged grassed areas with topsoil and sod.

15 Side Road, Regional Road 3 (Trafalgar Road) to 300m E of Trafalgar Road - Resurfacing

Full depth asphalt removal, curb repairs in pre-identified areas. Storm sewer repairs and full width asphalt. New sidewalk on the north and south sides in front of the school. Restoration of driveways (full aprons, or full width to the damaged limit) all damaged grassed areas with topsoil and sod.

22 Side Road, Regional Road 25 (Hwy 25) to Pit Entrance east of Third Line - Resurfacing

Pulverize existing asphalt into granular base, re-grade pulverized granular material. Repave asphalt full width of road. Restoration of driveways (full width to the damaged limit) all damaged grassed areas with topsoil and sod or seed.
